Optimization

Optimisation helps to balance dates and resources better under defined target conditions.

Optimisation in Rillsoft Project

Typical Goals

  • reach the project finish date

  • smooth resource utilisation

  • reduce overload

  • position activities more favourably within a subproject

  • make sensible use of available buffers

Prerequisites

Optimisation is only useful when the basic plan is reliable:

Check prerequisites for optimisation
  • activities are formulated correctly

  • links are correct

  • resource demand is plausible

  • calendars and non-working days are maintained

  • fixed activities are set deliberately

Limits

Optimisation does not replace a business decision. It cannot automatically make a poor plan correct. After every optimisation, check the schedule logic, resource effect, and critical path.

Check the optimisation result

Optimisation — Step By Step

  1. Make sure the schedule is technically checked and stable (links, durations, resource demand).

  2. If required, set a target finish date in the project properties and fix activities whose dates must remain unchanged (activity properties, General tab, Schedule area, Fix option).

  3. Click Project > Schedule > Other functions > Optimize resource utilization.

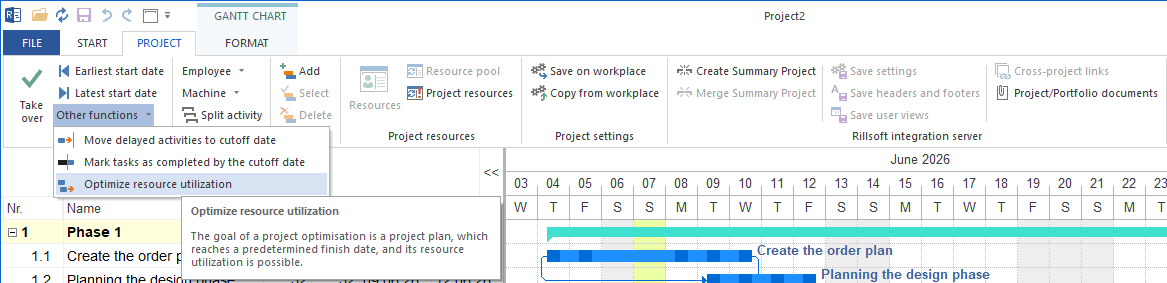

Optimize resource utilization in the Project ribbon
  1. Rillsoft Project calculates the optimised plan and shows the result in the Gantt chart.

  2. Check the result. If it does not fit, undo the optimisation with Undo (Ctrl + Z) and adjust dates, fixations, or priorities.

Optimise individual subprojects via the Optimize resource utilization command in the context menu of the subproject.

Influencing Factors Of The Optimisation

The optimisation evaluates the following settings from the project and activity properties:

Influencing factor

Meaning

Target finish date

Finish date set in the project properties that the optimisation aims for. Activities are arranged as early or as late as possible.

Even resource utilisation

Activities are moved within their buffer to reduce utilisation peaks.

Overloads

Activities are moved to resolve resource overloads — even if the finish date becomes later as a result.

Individual subproject

The Optimize resource utilization command in the context menu of a subproject optimises only that subproject; the rest of the plan remains unchanged.

Fix

Activities with the Fix option enabled (activity properties, General tab, Schedule area) are not moved.

Priority

Projects or activities with a higher priority are treated preferentially in conflicts.

Note: when optimising personnel resources, the hierarchy employee → team → role applies: if employees are assigned, the contained teams or roles are ignored during optimisation.

Check Result

After the optimisation, always check:

  • Did the critical path change?

  • Did fixed activities remain in their position?

  • Are new resource overloads created in other areas?

  • Is the finish date realistic?

  • Are all business dependencies still valid?

If the result is not acceptable: Ctrl + Z returns the plan to the state before the optimisation.

Show Free Float

Free float gives an overview of the earliest possible start and the latest possible finish of the activities and subprojects in the Gantt chart. The calculation runs against the next fixed frame in the schedule and no earlier than the cutoff date; on subproject rows, the line shows the envelope of the contained activities, not a buffer of its own. This helps to assess the available planning flexibility before an optimisation or plan change.

To activate the free float display:

  1. Select the Calculation of free float check box under File > Settings > General > Extended.

  2. Confirm with OK.

Activate Calculation of free float under File > Settings > General > Extended
  1. Select Gantt chart Format > Show > Free float.

Show free float in the Gantt chart

Note

When Calculation of free float is disabled, the earliest and latest possible start and finish dates are not available in the activity table. See also Customize Views: Filters, Format, Custom Views.
